Dashboard view monitoring a 3D print farm production queue

Print Farm Dashboarding: What to Track, What to Ignore, and How We Actually Use the Numbers

After a power, network, or controller interruption, a print farm should not restart from the dashboard alone. The safe sequence is to freeze automatic actions, compare each machine's physical condition with its recorded state, bound every potentially affected lot, reconcile usable quantities, and release machines one branch at a time with named approval. A green screen is evidence of connectivity, not evidence that parts, queues, and promises are correct.

How we reconcile a print farm after an interruption

An interruption can leave three different truths: what the scheduler intended, what the machine controller last reported, and what is physically on the bed or in WIP. Restart control exists to make those truths agree before new work consumes material or hides the boundary.

Restart gate Operator evidence Release decision
Event boundary Start and recovery time, affected power/network zone, last known good event Defines which machines, lots, files, and transactions require review
Physical truth Machine state, bed contents, tool position, temperatures, alarms, loose or shifted parts Continue only when the part and machine remain inside a qualified recovery path
Digital truth Assigned job, file revision, reported progress, queued action, duplicate-send risk Correct stale or conflicting records before commands resume
Quantity truth Accepted, held, rejected, replacement-open, packed, and remaining counts Prevents interrupted output from being counted twice or silently lost
Promise truth Minimum useful quantity, receiving-ready date, inspection and pack-out status Updates the buyer promise from accepted output, not recovered machine count

The eight-step controlled restart

  1. Stop automatic resends, queue advancement, packing moves, and status notifications until the interruption boundary is known.
  2. Record the event window and identify every affected electrical, network, controller, storage, and software branch.
  3. Walk the floor. Photograph or record each machine's physical state before clearing alarms, removing parts, or homing axes.
  4. Compare physical state with the assigned file, revision, material, lot, progress record, and last confirmed event.
  5. Place uncertain output on hold. Do not count a completed motion path as an accepted part without the normal inspection evidence.
  6. Reconcile mutually exclusive quantities: accepted, held, rejected, replacement-open, packed, shipped, and remaining. Resolve duplicates and gaps.
  7. Restart one representative machine per affected branch, verify its output, then release the rest of that branch under named authority.
  8. Recalculate usable capacity and buyer promises, including inspection, pack-out, replacement work, and recovery reserve.

When a print may resume and when it should be restarted

Resume is appropriate only when the machine supports a qualified recovery path and the part has not lost adhesion, position, temperature control, material condition, or traceable job identity. A visually plausible part is not enough. If the interruption creates an uninspectable internal risk, an uncertain file state, a shifted coordinate system, or an unknown material history, the honest disposition is hold or restart.

We also separate machine release from lot release. A printer can be healthy enough to run a verification piece while the interrupted lot remains held pending inspection or buyer disposition.

What buyers should ask a production supplier

Ask how the supplier identifies affected work, prevents duplicate commands, separates held output from accepted quantity, proves return to service, and updates delivery promises after an outage. For repeat or multi-SKU work, send controlled files, revision identity, acceptance criteria, minimum useful quantities, packaging, labeling, destination, and need dates through the managed production intake. Straightforward released parts can use the instant quote.

Build interruption recovery into the production handoff

JC Print Farm can review lot identity, accepted-quantity rules, staged releases, inspection, packaging, and recovery priorities before production begins.

Print-farm restart FAQs

Does a connected dashboard prove the farm recovered correctly?

No. It proves that some systems are communicating. It does not prove that physical WIP, assigned files, material, lot identity, quantities, or buyer promises agree.

Should every interrupted print be scrapped?

No, but every interrupted print needs a defined disposition path. Resume only when the machine, material, geometry, and inspection plan can support a controlled recovery decision.

Why restart one machine per branch first?

A bounded verification run can expose a shared power, network, configuration, material, or controller problem before the same failure is multiplied across the fleet.

A production dashboard needs a controlled manual-override path because the physical farm will occasionally know something before the software does. The safe response is not to hide the mismatch or let an operator silently edit a number. We record the observed state, preserve the system state, bound the affected work, name the decision owner, and reconcile both records before the order advances.

How we control manual overrides and state reconciliation

Scanners miss events, printers disconnect, labels get damaged, carts move during recovery, and inspection can change the usable quantity after a machine reports completion. A dashboard that forbids correction becomes fiction. A dashboard that accepts unexplained correction loses traceability. The useful middle is a temporary, visible exception state.

Field What the operator records Why it matters
Observed state What is physically present now, including quantity and location. Lets the team protect real WIP immediately.
System state The unedited event, count, timestamp, and source. Preserves the discrepancy for diagnosis.
Boundary Machines, lots, SKUs, containers, and time window affected. Prevents a local mismatch from contaminating good work.
Authority Who may correct, accept, hold, or release the state. Stops convenience edits from becoming shipment decisions.
Reconciliation evidence Count, scan, inspection, traveler, photo, or machine record used. Makes the correction repeatable and auditable.
Closure Final accepted state and prevention action. Returns the order to ordinary workflow.

The operator sequence when dashboard and floor disagree

  1. Freeze the affected movement. Do not pack, combine, or relabel questionable WIP.
  2. Capture the dashboard state before correction, including source and last-confirmed time.
  3. Count and identify the physical units by SKU, revision, lot, and disposition.
  4. Determine the smallest credible boundary; unrelated work should keep moving.
  5. Enter a temporary exception with an owner and next verification event.
  6. Reconcile accepted, held, rejected, replacement, packed, and shipped quantities.
  7. Release the state only when the system and physical handoff agree.

A manual quantity change cannot, by itself, make parts acceptable. Printer completion, inspection acceptance, pack-out, and shipment release are different decisions. We keep those states separate so an operator fixing a missed scan cannot accidentally authorize downstream work.

When overrides reveal a process problem

We review overrides by cause, location, shift, machine, SKU family, and age. Repeated corrections can point to an awkward scan point, unclear container identity, unreliable device, duplicated label, training gap, or a dashboard design that asks for confirmation at the wrong moment. The goal is not zero overrides. It is fewer unexplained mismatches and faster bounded recovery without corrupting the production record.

What a production buyer should ask

Ask whether corrected quantities retain the original event, who can change order state, how the supplier isolates affected WIP, and what evidence closes the discrepancy. For repeat releases, multiple SKUs, inspection requirements, packaging, or destination control, use the managed farm intake. For straightforward released files, use the instant quote.

Build the order around controlled physical states

JC Print Farm can review files, revisions, materials, quantities, inspection, packaging, destinations, and release cadence before work enters production.

Manual-override FAQs

Should operators be allowed to correct dashboard data?

Yes, through a controlled exception that retains the original state, reason, evidence, owner, and release decision. Silent edits are the problem.

Does a physical count overrule the printer completion count?

It establishes what is present, not what is acceptable. Inspection and disposition still determine usable quantity.

When is reconciliation complete?

When every affected unit has one current state, the physical location agrees with the record, downstream handoffs are correct, and a named owner closes the exception.

A production dashboard is trustworthy only when every displayed state says when and how it was last confirmed. A green tile copied from yesterday's queue is not visibility. It is an undocumented assumption that can hide a stopped machine, held lot, missing material, or incomplete pack-out.

How we keep dashboard states from going stale

We separate an event from an inferred state. A printer finishing a job is an event. The order becoming accepted stock is a later state that requires inspection and quantity reconciliation. The dashboard must not silently promote one into the other.

Displayed state Required confirmation Stale-state action
Running Machine or operator event tied to the released build and printer Expire to unknown when the expected heartbeat or check is missed
Completed Physical unload and produced quantity recorded Do not count as accepted capacity
Accepted Inspection result, accepted quantity, revision, and lot identity Hold from pack-out until evidence is restored
Material ready Correct material identity, condition, quantity, and job allocation Return the job to a readiness block
Packed Pack quantity, label, destination, and any kit reconciliation Do not report shipment-ready
Released Named release authority and carrier or pickup handoff Keep the promise open until handoff is confirmed

Unknown is a valid production state

Operators are often pressured to keep dashboards green. We prefer an explicit unknown state with an owner and next check. It exposes missing evidence early. Guessing preserves a clean screen while moving the surprise into inspection, packing, or the customer promise.

The five-field freshness record

  1. Object: the exact order, lot, printer, material allocation, or package.
  2. State: a controlled value such as running, watch, held, accepted, packed, or released.
  3. Evidence: the event, scan, inspection, or named observation supporting that state.
  4. Confirmed at: the timestamp used to judge whether the state is still current.
  5. Owner and expiry: who must reconfirm it and when it becomes unknown.

This is deliberately simpler than collecting every possible machine signal. The goal is not telemetry volume; it is knowing which production decisions remain safe.

What buyers can ask a production supplier

Ask when completed units become accepted units, how held material is excluded from available quantity, what happens when a status update is stale, and who owns the next confirmation. For a controlled recurring or multi-SKU release, send the revision, quantities, acceptance rules, packaging, and delivery events through the managed farm intake. Released straightforward files can use the instant quote.

Build the production record around usable output

JC Print Farm can review release readiness, accepted quantities, inspection, packaging, and replenishment requirements before production begins.

Dashboard state FAQs

Why not keep the last known status until someone changes it?

Because production states have different useful lives. A material check may remain valid until assignment changes, while a running-machine signal can become misleading quickly after a missed event.

Should machine telemetry be the system of record?

It can support machine state, but it cannot by itself prove revision identity, accepted quantity, inspection disposition, pack-out, or shipment release.

Does an unknown state mean the order failed?

No. It means the evidence is not current enough for the next decision. The correct response is a bounded confirmation task, not an optimistic assumption.

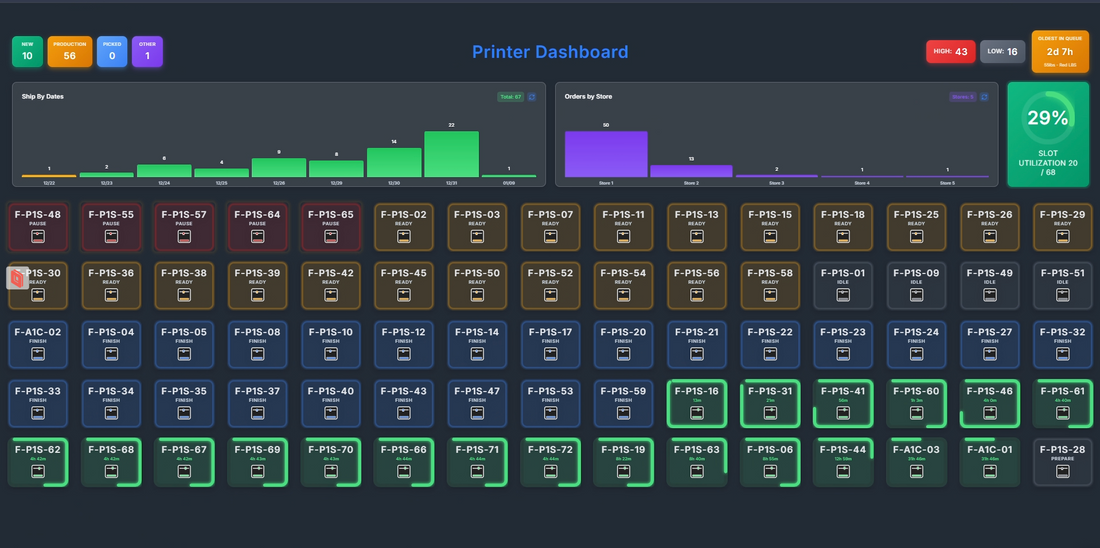

Dashboard view monitoring a 3D print farm production queue

Print farm dashboards are easy to do badly. A room can have big screens, colorful charts, and still miss the things that actually hurt output: stalled queues, machine-lane drift, overdue reprints, or a material lane getting risky before the next shift sees it.

The point of dashboarding is not to make the farm look advanced. The point is to make weak signals visible early enough that operators can protect delivery dates, repeatability, and labor time.

Direct answer: The best print-farm dashboards track queue health, machine-lane stability, blocked work, reprint pressure, material readiness, and due-date risk. We ignore vanity metrics that look impressive but do not change a production decision. If a number does not help us route, escalate, contain, or ship, it does not deserve prime dashboard space.

Short version

  • Dashboards should help operators act, not admire the room.
  • The most useful screens are usually queue status, due-date risk, reprint load, and machine-lane health.
  • Stable farms watch for drift and blockage earlier than most shops think they need to.
  • Pretty metrics like total printers online or lifetime parts printed rarely solve today's problem.
  • If you need help building a repeatable production workflow, start with farm intake; if your files are stable and you mainly need price direction, use the instant quote tool.

What we want a dashboard to answer fast

Questions that matter

  • What is late, blocked, or at risk today?
  • Which lane is drifting or producing more reprints?
  • What jobs are waiting on review, material, or approval?
  • Where is the next labor bottleneck coming from?

Questions that waste dashboard space

  • How many printers exist in total?
  • How many lifetime parts have we ever printed?
  • Which chart looks most impressive to outsiders?
  • What number moves but changes no operator action?

1. The first dashboard should be queue truth, not machine theater

If a print farm has only one screen that everyone trusts, it should answer the simplest production questions: what is released, what is printing, what is blocked, what is waiting on human action, and what is at risk of missing its promised handoff.

That matters because a lot of output pain does not start with a dramatic printer failure. It starts with silent waiting: a file that never got released, a part that needs confirmation, a plate that finished but did not move, a reprint that nobody prioritized, or a shipment window that quietly narrowed.

Good queue visibility is why we care so much about release discipline in pages like How We Run Thousands of Identical Parts in a Real 3D Print Farm. The dashboard should make the production lane honest before it tries to make it pretty.

2. Lane-level health beats whole-farm averages

Average success rates across the whole room can hide the exact branch that is causing trouble. We care more about lane behavior: which machine class, profile family, or material branch is producing friction right now.

For example, if one lane starts generating more interventions, more rejected first articles, or more repeat nozzle-path maintenance, the right move is not to celebrate that the room average still looks acceptable. The right move is to surface that lane before it poisons delivery confidence.

This is one reason we build around standardized machine logic. Articles like Bambu P1S Fleet Reliability and Bambu P1S Maintenance Checklist for Print Farms exist because fleets scale better when operators can see and compare lane behavior clearly.

3. Reprint load is one of the most honest metrics in the room

A farm can look busy and still be bleeding margin through reprints. That is why reprint pressure deserves its own visibility. Not because every reprint is a disaster, but because reprint volume reveals whether quality, release readiness, or routing discipline is drifting.

The best version of this metric is not just a single giant percentage. It is tied back to a lane, a part family, a material branch, or a defect reason. Otherwise the number looks informative but does not help you fix anything.

That operator mindset lines up with our broader quality-control logic in Quality Control in a 3D Print Farm: containment matters most when the system tells you where the risk actually lives.

4. Material readiness matters more than raw inventory count

A dashboard that says "we have ten spools" is much less useful than one that says which material lanes are ready for which jobs. Production material status is not just stock on hand. It includes dryness confidence, approved color lane, replacement availability, and whether the exact material-profile pairing is already proven.

If a due-date-sensitive run is queued on a material branch that is technically in inventory but not truly production-ready, the dashboard should expose that before the order reaches the front of the line.

5. Alert thresholds should reflect action, not paranoia

Too many alerts make operators numb. Too few alerts make the dashboard decorative. The threshold should match the next real decision.

Dashboard signal Why it matters Action it should trigger
Blocked jobs aging longer than expected Waiting work quietly kills throughput Escalate release, review, or customer clarification
Lane-specific reprints rising Points to drift, maintenance, or process mismatch Contain the branch and inspect the cause
Due-date risk climbing for a shipment wave Late awareness creates fake emergencies Reslot labor, re-sequence, or split releases
Material branch not ready for queued work Inventory alone can give false confidence Substitute, dry, hold, or reroute before the run starts
Intervention frequency rising on one lane Usually precedes a bigger reliability event Quarantine, maintain, or remove from priority work

6. What we ignore on purpose

Not every number deserves wall space. Some metrics are fine for monthly review but weak for real-time operations.

  • Total printers online: useful only if it is tied to the capacity lanes that matter for current orders.
  • Lifetime parts printed: good for storytelling, weak for daily action.
  • General utilization without context: a busy room can still be busy in the wrong places.
  • Single blended success-rate numbers: they often hide the branch that needs attention.

The rule is simple: if a metric cannot change routing, staffing, containment, or communication, it probably belongs in a report, not on the live board.

7. Dashboarding is really about labor allocation

The screen is not the product. The product is better operator timing. A strong dashboard helps the team put labor where it matters most: releasing work, clearing blocked orders, protecting due dates, servicing weak lanes, and handling reprints before they become shipment problems.

This is especially important in rooms that do not have round-the-clock staffing. The dashboard should make the next staffed window more productive, not just create a prettier history of what already went wrong.

8. The order-level control record behind the wall dashboard

A wall board is a summary, not the production record. For repeat work, each order still needs a controlled record that tells the operator what may run and what must remain on hold. Without that layer, a dashboard can show a healthy queue while the wrong revision, color, quantity, or inspection rule is moving through it.

At minimum, the order record should connect the dashboard status to the decisions below:

Control field What the operator needs to know Why it belongs in the production system
Released revision The exact file package and revision allowed to print Prevents an old export from looking like valid queued work
Quantity state Ordered, released, completed, accepted, rejected, reprinted, and shipped counts Stops finished quantity from being confused with usable quantity
Approved process baseline Material, color, orientation, profile family, and any approved substitutions Protects repeat orders from quiet process drift
Inspection gate First-article status, critical checks, cosmetic boundary, and release authority Keeps quantity from outrunning approval
Packaging and destination Pack count, labels, shipment waves, and delivery destination Makes downstream labor visible before printing consumes the schedule
Exception owner Who must resolve a hold and what evidence closes it Prevents blocked work from aging with no accountable next action

This is why our buyer-side guidance asks for more than an STL and a total quantity. The 3D Print Farm Quote Checklist for 100+ Production Parts explains the handoff information that makes a production record usable, while the production quality-control guide explains when the first-article gate should stop or release quantity.

9. We do not promise capacity from printer-hours alone

Nominal printer-hours are useful for rough planning, but they are a dangerous delivery promise by themselves. A 10-hour job does not consume only 10 hours of theoretical machine time. It also consumes a compatible lane, launch attention, material readiness, unloading and inspection labor, packaging time, and some recovery capacity if the first output is rejected or a branch goes down.

For that reason, the dashboard should separate at least four kinds of load:

  • Committed machine load: released work already assigned to compatible production lanes.
  • Operator-touch load: setup, plate change, inspection, sorting, packing, and exception handling that must happen in staffed windows.
  • Blocked or conditional load: work that may become real after an approval, material decision, or file correction.
  • Recovery reserve: room intentionally left for reprints, maintenance, and schedule containment.

Operator rule: do not use every open printer-hour as sellable capacity. If the board leaves no room for normal intervention, it is displaying a best-case fantasy rather than a production promise.

A useful capacity screen asks whether the job fits the correct lane and the correct labor window, not merely whether enough machines exist. This is the same logic behind our high-mix scheduling framework and our staged approach to planning a 2,000-part production run.

10. Queue age needs a reason code, an owner, and a next review time

A red “blocked” badge is not enough. The board should tell the team why the order is blocked, who owns the next decision, and when the block will be reviewed again. Those three fields turn a status into work.

Block reason Normal owner Useful next action
Revision or file ambiguity Project intake / buyer contact Confirm the released package before another plate starts
First article not approved Quality / designated approver Record approval, conditional approval, correction, or rejection
Material lane not ready Material owner / production lead Dry, replenish, validate a substitute, or move the release
Machine branch contained Maintenance / production lead Move safe work, diagnose drift, and define the return-to-service gate
Packaging or shipping dependency Fulfillment owner Confirm pack materials, labels, destination, and shipment wave

We care about the age of the block because silent waiting is often more expensive than visible printing time. Once a job crosses its review threshold, the dashboard should force a choice: clear it, reschedule it, split the release, or communicate the risk. Leaving it red for another day is not a decision.

11. The daily cadence: release, contain, recover, and hand off

Dashboards become useful when the team reviews them at predictable decision points. The exact clock time depends on staffing, but the operating sequence is stable.

  1. Start-of-window release: verify what is ready, what is due soon, and which lanes are safe to load.
  2. Mid-window exception review: check aging blocks, first-article holds, reprint pressure, and material branches that could strand the next launch.
  3. End-of-window recovery check: decide which reprints or maintenance actions must be completed before unattended work is released.
  4. Shift or day handoff: record what changed, what remains contained, and which decision the next operator must make first.

The handoff matters because a dashboard without written exception context makes the next person reconstruct the room from scratch. Good production software should shorten that reconstruction, not create another place to hunt for it.

12. The exception clock: when a dashboard must force a decision

A blocked job needs more than a red status. In a working print farm, every exception has a clock: when the condition was discovered, when it was last reviewed, who owns the next action, and when the delay begins to threaten a promised release. The clock is not a universal number. A cosmetic question on stock replenishment and a failed first article for tomorrow's line-side kit do not deserve the same escalation window.

Operator rule: age exceptions against their next decision deadline, not against an arbitrary dashboard color. The purpose is to create enough time to contain, recover, split a release, or tell the buyer the truth before a shipment becomes late.

Exception Evidence the board should retain Decision the clock must trigger
First article fails Part and revision, failed characteristic, affected lane, images or measurements, quantity already exposed Correct and rerun a bounded proof, request a documented deviation, or stop the release
One printer branch drifts Last known good output, first suspect output, machine and profile identity, work routed through the branch Contain that branch, inspect exposed quantity, and move only compatible work to qualified lanes
Material is not release-ready Specified grade and color, lot or spool status, conditioning status, approved-substitution boundary Restore the approved material path, obtain buyer approval for a change, or replan the wave
Accepted count falls behind Completed, accepted, held, rejected, reprint-open, packed, and shipped quantities Schedule reprint debt and revise the next useful shipment quantity
Buyer decision is pending Question asked, options and consequences, named approver, last contact, decision-needed time Escalate, release unaffected work, or move the promise with an explicit dependency

13. Restart evidence belongs beside the alert

Closing an alert because a printer is moving again is weak production control. The dashboard should link the correction to evidence that addresses the original failure mode. If a nozzle-path problem caused incomplete features, the restart check must examine those features. If fit failed, a pretty replacement part is not enough; the controlled fit check has to pass. If the problem was revision ambiguity, machine output proves nothing until the released file identity is restored.

  1. Contain: stop the suspect branch and identify the exposure boundary.
  2. Correct: record what changed without silently changing the approved production baseline.
  3. Prove: run the smallest useful bounded sample and test the characteristic that failed.
  4. Release: name who accepted the evidence and which quantity or branch may resume.
  5. Watch: keep a defined early-run check until repeat output shows the correction is stable.

This connects dashboarding to real quality control. Our production inspection guide covers first articles, containment, and change control; the high-mix scheduling guide explains how recovery work competes with ordinary releases.

14. Translate internal exceptions into buyer-facing promise impact

Customers do not need a feed of every nozzle change or operator note. They do need early communication when an exception changes accepted quantity, the next useful shipment, an approval dependency, or the committed date. A useful buyer update states what is affected, what remains safe, what evidence is being gathered, who owns the next decision, and when the next update will arrive. It avoids pretending that completed machine cycles equal accepted product.

For a repeat-production RFQ, give us the governing files and revisions, quantities by SKU, material and color, critical fit or inspection points, pack units, destinations, and the date each quantity becomes useful. If those inputs are stable, use the instant quote flow. If the job needs staged releases, approval gates, replenishment logic, or multi-SKU coordination, use the managed production intake. Review our production 3D printing service and repeat production runs for the broader operating model.

Measure promise health, not printer busyness

A farm can show high machine utilization and still miss the buyer's need. Printers may be occupied by reprints, unreleased work, excess quantity from the wrong SKU, or parts waiting on inspection. The useful question is not “How many printers are moving?” It is “Is the next accepted, correctly identified, receiving-ready quantity on track for the event the buyer actually cares about?”

Operator rule: utilization is a capacity signal, not proof of delivery performance. Judge promise health from released demand through accepted quantity, pack-out, shipment, and the buyer's minimum useful quantity.

Signal What it can tell an operator What it cannot prove
Printer utilization How much scheduled machine time is occupied That the correct parts will be accepted or arrive when useful
Cycle completions How many planned builds have ended Accepted units; a completion may still be held, rejected, or misidentified
Accepted quantity by SKU and revision How much conforming output is available for pack-out That labeling, kits, documents, or freight are ready
Minimum useful quantity status Whether the next release changes the buyer's operating outcome Whether the entire purchase order is complete
Receiving-ready date Whether accepted output, identity, packaging, records, and transport align Uncontrolled delay inside the buyer's facility after compliant receipt

Build the board around release demand and quantity states

Start each promise with a released part or SKU, revision, required quantity, destination, minimum useful quantity, and need event. Then keep quantities in states that cannot overlap: not started, running, completed-awaiting-review, accepted, held, rejected, replacement-open, packed, tendered, and delivered. If one unit appears in two states, the board is giving false confidence.

  1. Anchor the demand: show the approved quantity and the event it supports, not a floating job count.
  2. Expose the constraint: identify whether the limiting step is material release, machine time, inspection, reprint debt, pack-out, approval, or transit.
  3. Forecast the next useful release: report the earliest accepted quantity that helps the buyer, plus the remaining balance.
  4. Age exceptions against decisions: use the next action deadline and promise consequence, not an arbitrary red-status timer.
  5. Reconcile at handoff: accepted, held, replacement-open, packed, and shipped quantities must explain the released demand.

Use three tests before calling a production promise healthy

Technical readiness: the released file, revision, material, process, and inspection method are unambiguous. Quantity readiness: the accepted-unit forecast covers the next minimum useful release after expected loss and reprint work. Handoff readiness: labels, kit structure, documents, destination, carrier timing, and exception authority are defined. A green printer fleet with any one of these tests unresolved is not a green customer promise.

For a file-ready, straightforward order, use the instant quote flow. For staged releases, multiple SKUs, inspection gates, kitting, or receiving requirements, use the managed production intake. Our production 3D printing service, repeat production runs, and inspection guide show how those handoffs connect.

What a production buyer can reasonably ask a print farm

A buyer does not need access to the internal dashboard, but high-trust production conversations should produce clear answers to a few operational questions:

  • How do you distinguish completed parts from accepted and shipment-ready parts?
  • What happens when a first article fails or one machine lane starts drifting?
  • How do you keep an older revision from re-entering a repeat order?
  • Can a large order be released and shipped in controlled waves?
  • Who owns a blocked decision, and when does the schedule impact get communicated?

Those questions test whether the farm is controlling the order, not whether it owns attractive monitoring software. If your project already has stable files, quantities, material, and acceptance requirements, start with the instant quote flow. If the release plan, repeat cadence, packaging, or approval path still needs operator review, use JC Print Farm intake. You can also review our production 3D printing and bulk and batch production service paths.

What a buyer should understand about dashboarding in a real print farm

Buyers do not need to care about every internal metric. But they should care that the farm they use has visibility into the things that protect schedules and repeatability. If a production partner cannot describe how it watches blocked work, reprint load, lane drift, and release status, the fancy software label does not mean much.

That is part of the larger buyer-education theme behind What Print Farms Actually Want From a Production 3D Printer and How a Real Print Farm Evaluates New Printers Before Buying Another Machine: reliable output is usually a systems question before it is a hardware bragging contest.

Where this connects to JCSFY service paths

Best fit for scoped production work

Best fit for faster buyer actions

Final takeaway

The best dashboard in a print farm is not the one with the most numbers. It is the one that makes the next good decision obvious. When queue truth, due-date risk, reprint pressure, and lane health are visible early, the room gets calmer, output gets cleaner, and customers get fewer surprises.
